Kyle of Lochalsh Lead Pipe Replacement

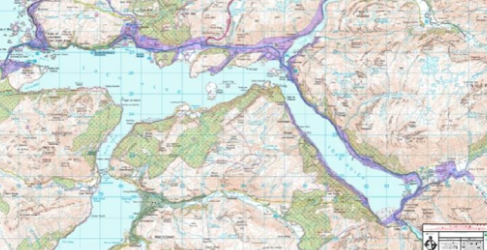

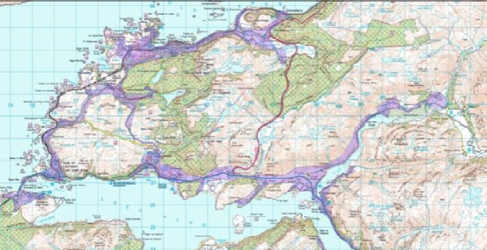

Project overview
Scottish Water is conducting a lead pipe replacement programme in the area served by Kyle Water Treatment Works (WTW), covering 2,200 homes and businesses from Glenshiel to Kyleakin and Stromeferry.
The programme includes eight phases of water quality sampling, where customers will be contacted by letter and encouraged to book appointments for water sampling, either by mail or online. Appointments can be booked online here.
The aim is to detect any lead present in the final section of Scottish Water’s pipework or the supply pipes belonging to property owners and support their replacement.
As well as being beneficial for customers, this work has the potential to simplify the water treatment process at Kyle WTW – one element of which is designed to minimise the potential impact of lead pipes on water quality at customer's taps.
The project will take about two years, with contractors RPS and Morrison Construction handling the work, while customer engagement continues through various channels, including in-person events.
At A Glance
- Lead pipe replacement
- 2,200 homes and business
- Eight phases of work
- Two-year duration
- Delivered by Morrison Construction and RPS
Extensive sampling measures taking place
The project looks to inform customers who have lead pipes and support their replacement.
Phases
- Phase 1 commenced in November 2023 and is progressing steadily, with almost 60 percent of properties within Invershiel sampled. Work is on-going to make contact with the remaining customers who have not yet responded to make an appointment. An information event was held before sampling began to allow residents find out more about the project.
- Phase 2, which covers Dornie, Ardelve and Bundalloch, commenced in February 2024. A further information event was held for residents at Inverinate and Loch Duich Community Centre in April 2024.
- Phase 3, covering Drumbuie, Duirinish, Balmacara and Auchtertyre, commenced in May 2024. A drop-in information event for residents was held at the Cosy Corner Cafe in Balmacara Square in May 2024.
- Phase 4 - commenced August 2024 and covers properties to the south of Plockton, including Drumbuie, Duirinish and Achnandarach
- Phase 5 - commenced August 2024 and covers Craig, Achmore and Stromeferry
- Phase 6 - commenced October 2024 and covers Kyle of Lochalsh, Badicaul and Erbusaig
- Phase 7 - Kyleakin
- Phase 8 - Plockton
Sampling work will be split up into eight phases.
Customers in each phase will be contacted via letter and encouraged to make a sampling appointment.
